Skip to content
Foxx Cyberfoxxcyber/docs

Strategy and the Risk Register

Capture business goals and the client's risk appetite, then run a scenario-based 5×5 risk register with inherent and residual scores, treatment and sign-off.

Security work should be able to answer "why does this matter to the business?" The Strategy tab records the answer; the Risks tab holds the register that every recommendation is weighed against.

Business goals

Open Strategy, choose Add goal and add each goal the business is pursuing, with Save goal:

FieldNotes
Goal and DescriptionWhat the business is trying to achieve.
How security supports itThe link between the goal and the program.
Horizon90 days, 1 year or 3 years.
Priority1 to 3.
StatusProposed, active, achieved or dropped.
Target date and Business ownerWho owns the outcome, and by when.

Risks and roadmap items can link to a goal. The goal list shows how many open risks and open roadmap items point at each one, a goal's own page lists them under Risks to this goal and Roadmap work for it, and the board report has a section on the goals. Back to strategy returns to the list.

Risk appetite

The same tab holds the client's risk appetite, in leadership's words:

  • Appetite statement: how much risk the business will carry to reach its goals.
  • Never acceptable: the outcomes leadership will not accept at any score.
  • Accept up to score: the threshold on the 5×5 matrix, from 1 to 25 (new clients start at 6). Risks scoring above it need treatment or a documented acceptance.
  • Review every so many months (1 to 36, default 12), plus Approved by and Approved on.

Choose Save appetite to keep it.

The threshold drives the above appetite flags on the register, the client overview, the portfolio and the board report. Once the appetite has an approval date, its re-approval comes due in Monitoring.

The risk register

Open Risks → Add risk. Each risk gets a reference (R-001) and these fields, saved with Save risk:

FieldNotes
Title and ScenarioWrite the scenario: the threat, what it acts on, and the consequence.
CategoryStrategic, operational, compliance, financial, reputational, technology, third party or people.
Asset or processFree text naming what is at risk. Link the asset records the risk threatens under Assets at risk on the risk's page (Link asset), or from the asset register.
Likelihood and Impact1 to 5 each: Rare, Unlikely, Possible, Likely, Almost certain; Negligible, Minor, Moderate, Major, Severe. This is the inherent rating.
Residual likelihood and impactThe rating after treatment. Set both or neither.
In dollarsOptional. The exposure factor, events a year and the treatment's cost, which work out what the risk costs in dollars. See Risks in dollars.
TreatmentUndecided, mitigate, accept, transfer or avoid, plus a treatment plan.
Risk owner, Next reviewOne named business owner (the field suggests the client's contacts) and when the risk is next reviewed.
StatusOpen, treating, accepted or closed. A risk becomes accepted only when its owner accepts it in writing (see Written acceptance); the form keeps an acceptance but never starts one.
Business goalThe business goal it threatens.
Accepted by, Accepted on, Accepted untilShown on an accepted risk: who at the client accepted it, when, and until when. They cannot be edited when the owner signed.
On the never-accept listLeadership will never accept this risk, so it can only be treated, transferred or avoided.

How scoring works

  • Score = likelihood × impact, from 1 to 25.
  • Bands: Low 1 to 4, Moderate 5 to 9, High 10 to 16, Critical 20 to 25.
  • The current score is the residual score when both residual values are set, otherwise the inherent score. Lists, the portfolio and the report all use the current score.
  • A risk is above appetite when its current score is above the threshold and it is neither accepted nor closed.
  • Critical risks on the portfolio are open risks with a current score of 20 or more.

Risks in dollars

The In dollars section of the risk form puts a price on the risk, the way the CISSP does. It is optional, and a risk without it works as before.

The In dollars section of a risk: value at risk $1,000,000 from one linked asset, an exposure factor of 40 percent and 0.5 events a year, a treatment that cuts exposure to 10 percent and 0.1 events a year at $30,000 a year, and the single loss, annual loss and verdict worked out below

It starts from the value at risk: the sum of the values of the assets linked to the risk. Give each asset a value on its page; see Vendor and Asset Registers. Then fill in:

FieldWhat to put there
Exposure factorThe percentage of the value lost in one event, 0 to 100.
Annualized rate of occurrenceEvents per year. 0.5 is once in two years, and 0.1 is once in ten.
Exposure factor after treatmentThe percentage lost in one event once the treatment is done. Blank means unchanged.
Events a year after treatmentBlank means unchanged.
Treatment cost a yearWhat the treatment costs each year, in whole US dollars.

Save the risk, and the section works out:

  • Single loss expectancy (SLE) = value at risk × exposure factor: what one event costs.
  • Annualized loss expectancy (ALE) = SLE × events a year: what the risk costs a year.
  • After the treatment: the ALE with the after-treatment numbers, and how much a year the treatment removes.
  • Treatment: a verdict on the cost against the loss it removes. Worth it says how many dollars a year it saves beyond its cost, Breaks even means the two are equal, and Costs more than it saves says by how much.

The figures are worked out from the saved risk, so save to see them change. They are advice for a decision, not a forecast.

Dollars appear wherever the risk does:

  • the risk register has an ALE / yr column you can sort by, and its list heading says "expected loss $x a year across n live risks in dollars";
  • once any live risk is in dollars, the client overview has an Expected loss a year tile that opens the register sorted by ALE;
  • the board report and its PDF show Expected loss a year, and each top risk's ALE;
  • the client portal shows the same;
  • the Excel export carries the exposure factor, events a year and treatment columns, plus Value at risk, SLE and ALE a year, which are worked out and read only. See Import and Export.

Reading the register

The register shows two heat maps: Current (residual) and Inherent (before treatment). In each cell, the large number is how many live risks (open, treating or accepted) sit there, and the small number is the cell's score. Cells holding risks that score above the appetite are outlined. Choose a cell's number to list just those risks; Show every live risk goes back.

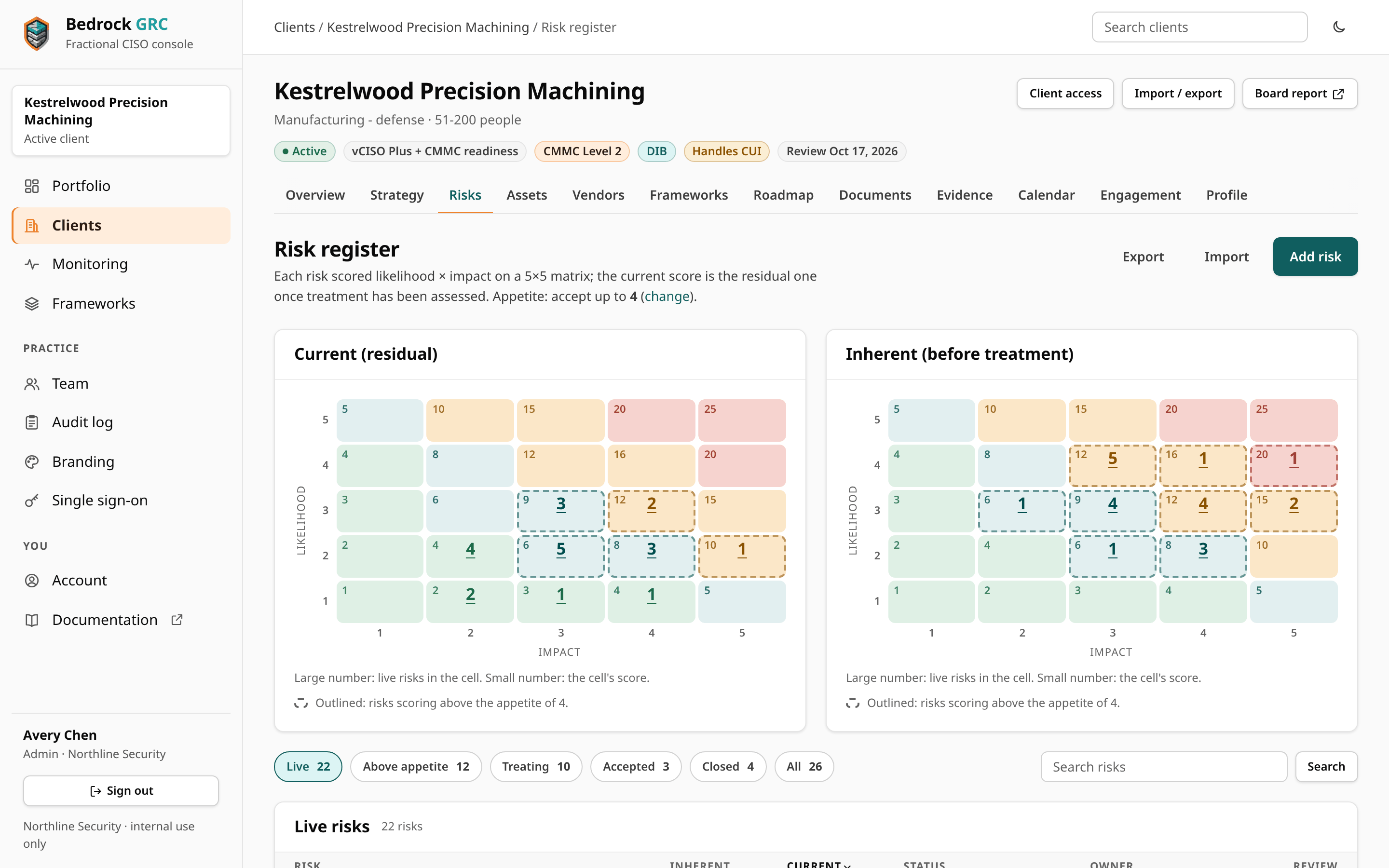

The risk register: the current and inherent heat maps with counts in each cell and outlined cells above the appetite of 4, and the Live, Above appetite, Treating, Accepted, Closed and All chips over the list

Under the heat maps, chips pick the view, each with its count: Live, Above appetite, Treating, Accepted, Closed and All. The list is headed by the view (Live risks, Risks above appetite, and so on), and Search risks finds a risk by reference, title, owner, category or goal. Choose a column heading to sort by it, including ALE / yr when risks are in dollars. Export and Import sit above the heat maps.

Connecting risks to the rest of the program

  • A roadmap item can say which risk it treats; the register shows how many open items each risk has.
  • Vendors and assets link to the risks they create or carry.
  • Open risks with a review date appear in Monitoring when the review comes due. Open risks without a review date are counted as loose ends.

Written acceptance

Accepting a risk is the client's decision, made in writing by a named owner who has seen the risk. A verbal acceptance, or one from someone who never saw the finding, will not stand up in a review. The Written acceptance card on a risk's page asks for that decision and keeps the record.

Ask for written acceptance takes:

  • Who accepts: one of the client's contacts. They need an email address. A risk scoring above the appetite can be accepted only by the client's executive sponsor.
  • Accept until: when the acceptance ends. It defaults to the appetite's review cycle from today, and can be up to three years away.
  • Note to them (optional).

With email on, the contact gets a link by email. Otherwise you get the link once, to copy and send yourself. The link is personal, works once and expires in 14 days. A new request for the same risk withdraws any earlier one, and Withdraw on a waiting request stops its link at once.

The page behind the link shows the risk as it stands, frozen when you sent it:

  • the scenario;
  • the score and its rating, against the client's appetite;
  • the appetite statement and the treatment plan;
  • the open roadmap work treating the risk, with each item's compensating control.

The contact types their full name and chooses Accept the risk or Decline, with an optional comment. Their name, answer and the time are recorded with exactly what the page showed. Accepting marks the risk accepted until the chosen date and shows Signed by the owner on it.

Some things end a request or an acceptance:

  • Editing the risk after sending withdraws the link. The contact sees that the request is out of date, nothing is recorded, and you send a new one.
  • A risk on the never-accept list cannot be asked about or accepted.
  • When the acceptance ends, the risk is open again the next day. It shows in Monitoring as Acceptance ends until then.
  • A lower appetite reopens the acceptances it no longer covers. When Accept up to score goes down, an accepted risk that now scores above it is open again, unless the executive sponsor accepted it in writing: only the sponsor may accept above the appetite. The page names the risks it reopened, so you can ask their owners to accept them again or treat them.

An acceptance recorded any other way shows Not signed by the owner: an older record, an import, or a signed acceptance whose details someone later changed. Send a written acceptance request to have the owner sign it.

The Written acceptance card on a risk accepted in writing: Accepted in writing by the executive sponsor until a date, the list of requests with one accepted and one withdrawn, and the form to ask again

Last updated November 18, 2026
